- Neighborhoods
-
Community
-
- Overview History Vision Newsroom News Releases Pilot Newsletter Media Contact Projects Volunteer
- Engage Milwaukie Events City Calendar Recreation Biking in Milwaukie Parks and Trails Directory North Clackamas Parks and Recreation Reserve a Room Library
- Schools North Clackamas School District MHS Student of the Month Public Safety Police Clackamas Fire District #1 Code Compliance Emergency Preparedness Emergency Notifications Garbage & Recycling
-
- Business
- Departments
-
Useful Links
-
- Jobs Alerts & Notifications Email Subscriptions Emergency Notifications Meetings City Services A-Z Mapping & GIS
- Contact the City Staff Directory Request a Public Record Report a Code Violation Report a Pothole Report Misconduct Schedule an Inspection Documents & Forms Documents and Reports Forms, Permits, and Applications
- Helpful Links Digital Archives Library Catalog Municipal Code Purchase a Parking Permit Paperless Billing Pay a Ticket or Utility Bill Urban Forest
-
King Road Improvements
Dates
May 2023 – September 2025
Project Status
In Design
Budget
$5,185,000
Contact
Tracie Heidt, SAFE Program Outreach
503.235.5881 ext. 181
milwaukiesafe@milwaukieoregon.gov
Camilo Alvarez Tuta, Associate Engineer
503.786.7605
tutac@milwaukieoregon.gov
Project Details
This project will repave the road and create improved connections for pedestrians and bicyclists. It will also build multi-use paths along King Road that connects to the recently constructed multi-use path on Linwood Avenue. This project includes funding from the Safe Access for Everyone (SAFE) program and the Street Surface Maintenance Program.

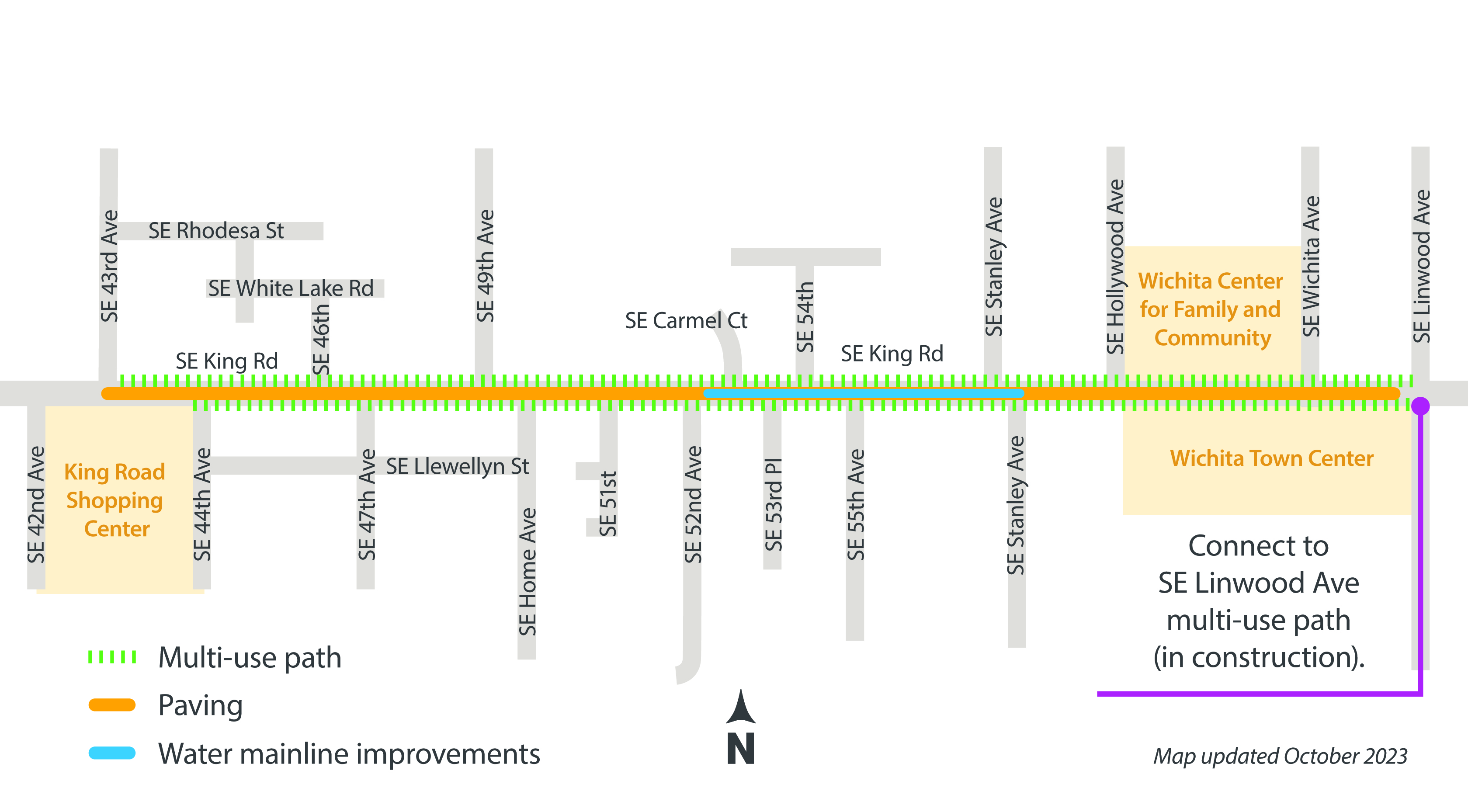

Proposed improvements:
- Build a multi-use path on both sides of King Road.
- Repave King Road between 43rd and Linwood Avenues.
- Update curb ramps at each intersection to current ADA standards.
- Remove a duplicate water mainline pipe on King Road between 52nd Avenue and Stanley Avenue that is no longer in use.
Project Schedule: Planned for fiscal years (FY) 2023 to 2025
- Engineering Phase: FY 2023-2024
- Construction Obligation Year: FY 2025 – FY 2026
- Construction Target Date: Spring 2025
- Completion Target Date: October 2026
King Road is an arterial street with a speed limit of 35 MPH. We will not lower the speed limit with this project, but we will enact other traffic calming measures to encourage vehicles to slow down.
Alerts & Updates
Update (11.22.24)
The 90% engineering design was submitted to the City for internal review the second week of November 2024. The City still anticipates construction to begin in Spring/Summer 2025.
Starting December 2024, the new City contact will be Camilo Alvarez Tuta. Check the full contact information at the top of this page
Update (7.29. 2024)
We are still designing this project and expect to put it out for bid in order to hire a contractor this winter. We anticipate construction to begin spring 2025.
Update (10.13.2023):
Conceptual 30% design has been submitted to the city for internal review. A Public Open House is scheduled for November 2nd from 5-6:30 PM at City Hall in the Dogwood Community Room (Rm 103) at 10501 SE Main Street.
Update (7.5.2023):
The project is currently in the design phase through April 2024. We expect construction to begin summer 2024 and last until fall 2025.
Update (5.25.2023):
Project is currently in data collection with an Open House tentatively planned later this year.
Update (4.24.2023):
Kittelson & Associates Inc. was awarded the agreement for design of the King Road Project by City Council at the April 4, 2023 meeting. Kittelson received the Notice to Proceed letter and is now collecting existing condition information about the project site. Otak is the subconsultant that will be collecting field survey data over the next month or so.
Update (3.10.2023):
Four King Road Request for Qualifications proposals were received on March 7, 2023. Interviews are scheduled for March 15th and Intent to Award will be posted by the week of March 20th.
